On this page
View In PDFAn aircon drain carries away the water that collects as the unit cools the room. Its route needs planning before ceilings and cabinets restrict access. If a pipe cannot drain properly or be reached for maintenance, a small problem can mean opening finished work later. Settle the route, connections and access with your installer while changes are still practical.

Plan the drain during aircon installation in a renovation, while those choices can still change. The installer needs to identify where the water will discharge, how the pipe can slope towards it and where future maintenance access will remain. Check and test the completed drainage before the ceiling or cabinets hide it.
This is a planning task for the homeowner and project team. Pipe sizing, supports, connections, drainage arrangements and testing belong to the qualified installer working to the selected equipment and local requirements.
Decide where the aircon water will drain

Cooling removes moisture from the room air, and that condensate needs a controlled route away from the unit. A nearby bathroom, balcony or external drain may suggest a destination. Proximity alone does not establish that the connection is appropriate.
PUB's specific requirements for water discharge distinguish air-conditioning condensate from water used to wash the equipment. The condensate arrangement must not cause public nuisance. The guidance also describes a conditional route to the sewer through a floor trap where there is no available surface outlet connected to the stormwater system.
The installer and relevant plumbing contractor should identify the actual arrangement for the property, including any conditions attached to it. “To nearest drain” leaves the decision unresolved. The quotation or coordinated drawing should show where the line terminates and who is responsible for that connection.
Washing water needs its own arrangement under the applicable requirements. A condensate line should not be treated as blanket permission to discharge every liquid generated during maintenance through the same route.

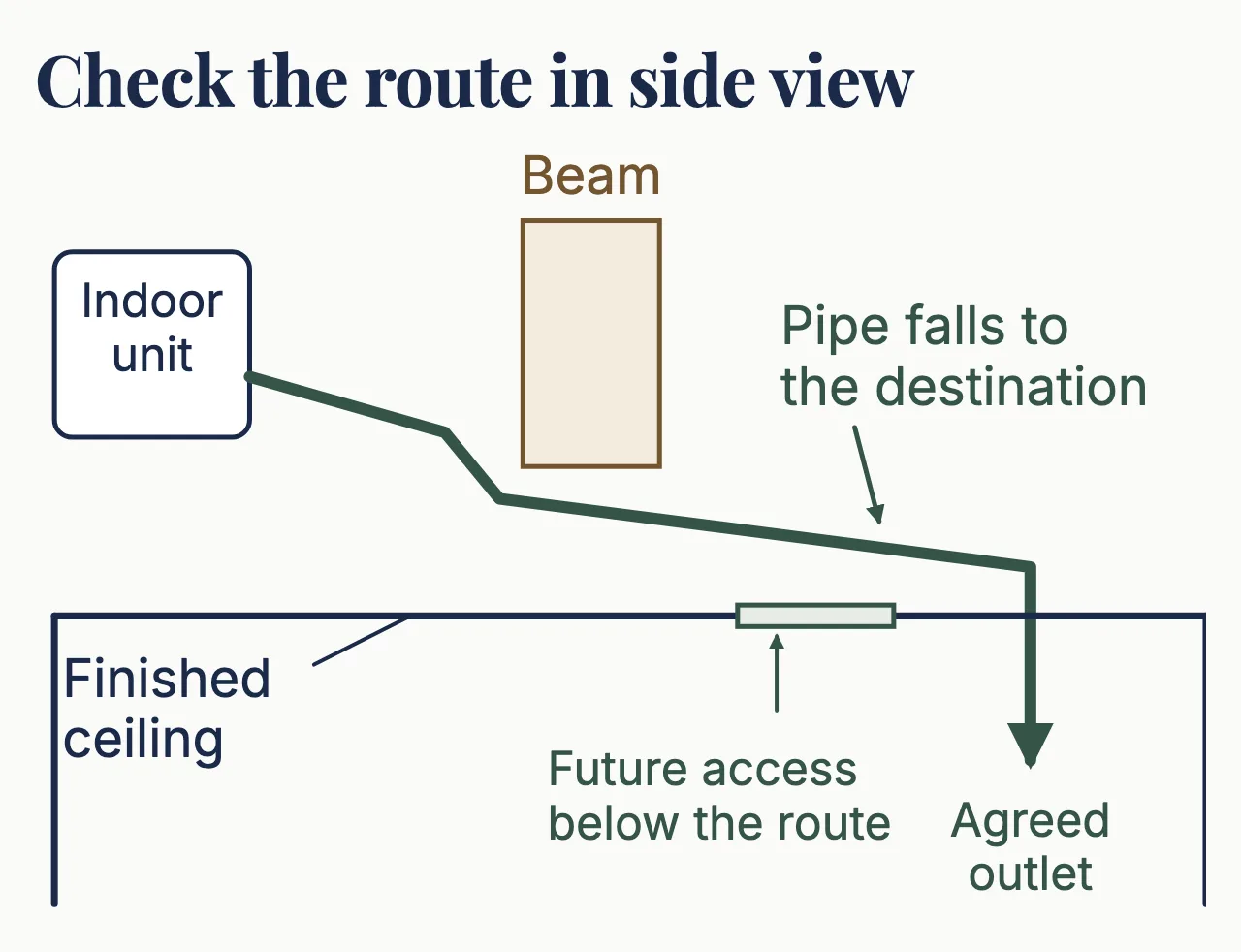

Show the pipe’s slope on a side-view drawing
A gravity drain relies on an appropriate downward route. A line on a floor plan shows where it travels horizontally, but it does not show whether it can maintain the required fall between the unit and the outlet.
The original installation guidance for a wall-mounted model illustrates downward drainage and arrangements that retain water. The exact pipe dimensions, support details and allowable installation depend on the selected equipment and the designed route. A generic slope copied from another model is not a substitute.
A section through the ceiling or bulkhead makes the spatial problem visible. It should locate the drain relative to beams, door heads, cabinetry and other services. The pipe also has an outside dimension after insulation, which needs to fit within the planned space.
If the route cannot work within the proposed enclosure, resolve that before finishing work. The options may include a different unit position, a changed ceiling or bulkhead, another approved destination or a separately designed drainage arrangement. Each can affect appearance, access and cost. Concealing the conflict does not remove it.
Coordinate the drain separately from the refrigerant pipes
The drain and the refrigerant pipes may share part of a visible trunking route, but they do different jobs. Agreement on where the aircon pipes will run is therefore incomplete unless it also resolves the drainage requirements.
A joinery drawing may leave space for a pipe bundle while placing a fixed panel over the drain connection. An electrical route may occupy the clearance that the drain needs to descend. These are coordination conflicts between otherwise ordinary pieces of work.
Use one coordinated drawing or marked-up section that the affected contractors accept. Identify who installs each portion, who forms openings and who makes good the surrounding finish. Where the line passes through a waterproofed or external element, include responsibility for the penetration detail.
The homeowner's decision is often visible versus concealed work. A concealed route can give a quieter room appearance, but it needs planned access where maintenance is required. A visible route can be easier to inspect, although it must still be properly designed and finished. The choice should be made with both appearance and future service in view.
Insulation and drainage solve different water problems
Water inside the drain must reach its destination. Moisture can also form on the outside of a sufficiently cold surface if the insulation arrangement is unsuitable. These are different paths to a wet ceiling.
Local manufacturer installation guidance addresses insulation of drainage pipework as well as the refrigerant piping. The selected materials and treatment of joints need to suit the installation conditions. An apparently generous thickness along a straight run does not describe what happens at a compressed section or connection.
For the homeowner, the useful review is whether the installed insulation is continuous as specified and whether changes of material or concealed joints have been dealt with. The technical acceptance belongs to the installer. Photographs taken before the ceiling is closed can preserve what was visible at that point.
This distinction matters later if a stain develops. A ceiling mark near an aircon route does not, by itself, identify a blocked drain. Its cause needs assessment; the handover record can help the technician understand what is hidden.
Leave access where the drain will need maintenance

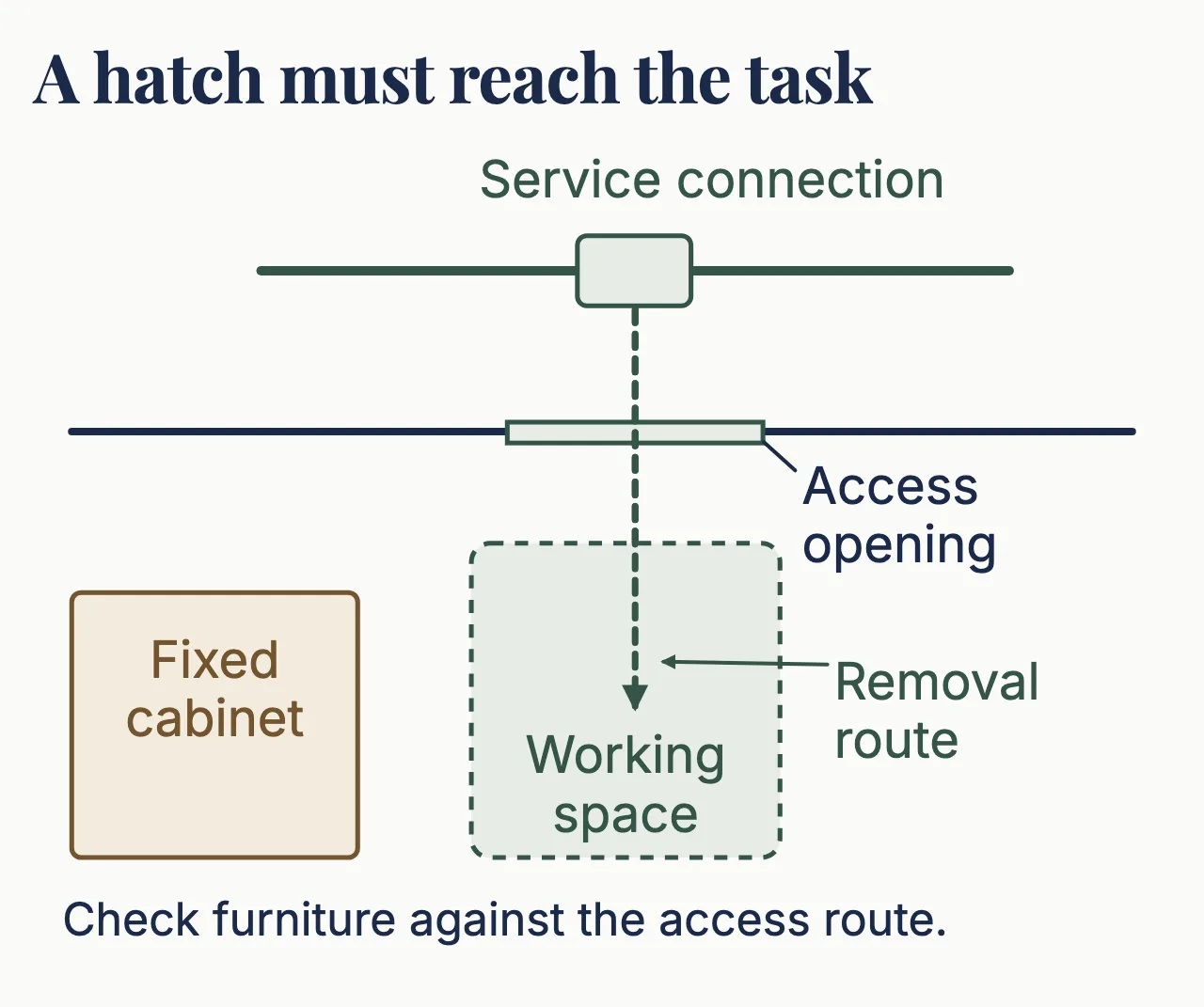

An access panel is useful only if it exposes the component that needs attention and gives enough working room. A small opening positioned for visual symmetry may leave the drain connection out of reach.
The installer should identify the parts of the unit and drainage arrangement that need service access. Coordinate those positions with ceiling framing and joinery, and preserve the removal direction of the relevant covers or panels. If a separately designed drainage device is included, its own power, service and fault-response requirements need to be part of the scope.
Also consider the route a technician will use to reach the opening. A panel directly over fixed tall furniture may exist on paper yet be difficult to use. The finished room layout matters as much as the unfinished ceiling.
The aircon buying guide covers the broader relationship between equipment, installation and upkeep. Drain access is one of the small design decisions that affects all three.
Inspect and test the drain before closing the ceiling
Before the ceiling is closed
- Route accepted
The final route, discharge destination and responsibility for the connection are recorded.
- Installation checked
The installer has completed the relevant inspection and drainage check, with any defects resolved.
- Access preserved
Panel positions and working access agree with the finished ceiling and furniture layout.
- Record retained
Room-referenced photographs and the final route are included in the handover information.
Before concealment, the installer should complete the relevant inspections and drainage checks for the installation, record the result and resolve outstanding defects. The main contractor should know that this is a dependency for closing the ceiling, rather than discovering it after boards are fitted.
A useful record identifies the units and routes checked, the method, the destination and the result. It also locates access panels and includes photographs with room references. “Water tested” without a location or result is too vague to help later.
A satisfactory pre-closure check is part of quality control, not a guarantee that a drain will never need maintenance. The handover should explain the normal care arrangement and the response to a leak or unusual condition. Do not improvise a drain-clearing method through an access panel.
Before approving the ceiling or wardrobes, ask the installer to show where each drain runs, where its water goes and how it can be reached later. Resolving those three points now gives the finished room space for the drainage it needs.
